The winning investor executing the 1,500 MW Ca Na LNG Power Plant Project is the Trung Nam - Sideros River Consortium, with a total implementation cost of VND 57,384.78 billion and an approved winning proposed electricity tariff of 3,294.22 VND/kWh.
On January 28, 2026, the People's Committee of Khanh Hoa Province issued Decision No. 339/QD-UBND, approving the investor selection results for the Ca Na LNG Thermal Power Project.
Accordingly, the winning investor selected to execute the Ca Na LNG Power Plant Project is the Trung Nam - Sideros River Consortium.
According to the approval, an LNG thermal power plant complex will be established in Ca Na Commune, Khanh Hoa Province, comprising a 1,500 MW power plant, an LNG terminal with a capacity of 1.0 - 1.2 million tons/year, and other auxiliary infrastructure to ensure national energy security.
 |
|

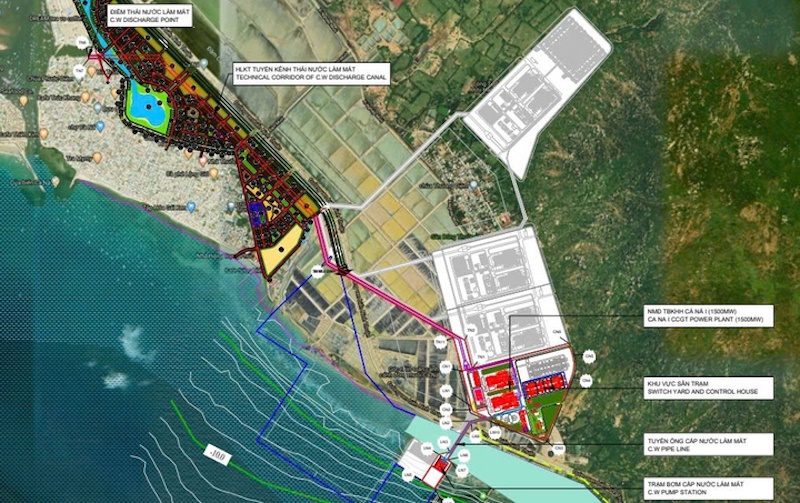

Planning layout of the Ca Na LNG Power Project.
|
The estimated land area used for the project is approximately 265.7 hectares (of which the land area including the LNG power plant area and technical corridors accounts for about 33.4 hectares; the water surface area accounts for about 232.3 hectares including storage and regasification facilities with 1 storage tank (~220,000 m3), LNG supply pipeline, an LNG import jetty, a 2,400-meter Eastern breakwater, and auxiliary infrastructure serving the LNG import port).
The project scale will be recalculated after completing all construction and land procedures.
The total project implementation cost is VND 57,384.78 billion; the proposed winning electricity tariff is 3,294.22 VND/kWh.
The project is scheduled for construction completion and operational commissioning before December 31, 2030, with an operational lifespan of 50 years from the date the investor is granted land allocation, land lease, or land-use purpose change decisions.
Decision No. 339/QD-UBND also noted that during contract negotiation and execution of the Ca Na LNG Thermal Power Project, the Trung Nam - Sideros River Consortium must commit sufficient capital (equity and debt financing); supplement relevant documents related to PowerChina regarding operation and maintenance (O&M) for similar projects; complete consular legalization during contract negotiations; and establish specific milestones as a basis for progress supervision and expediting.
The investor must also commit to completing construction and putting the project into operation before December 31, 2030 (in accordance with the schedule set out in the bidding dossier and in full compliance with the terms specified in the invitation to bid and commitments in the investor's bid dossier).
The Department of Industry and Trade of Khanh Hoa Province is assigned to negotiate the contract with the investor and submit it to the Provincial People's Committee for signing (noting opinions from the Department of Finance in appraisal report No. 8494/STC-DTNNS dated December 31, 2025 to ensure negotiations comply strictly with regulations); publicly announce investor selection results; publish major project contract information; and execute the investment project in accordance with Decree No. 115/2024/ND-CP, Decree No. 56/2025/ND-CP, and current regulations.
